See who is over-committed before the sprint starts, from assigned work, estimates and recorded leave.

Documented for version 1.2.1 · Verified against 932d12e

Install on your own Redmine →

On this page

A heatmap of who is committed to what, week by week, built from the work already assigned to them, its estimates, and the leave they have recorded. The question it answers is "can this team take on that?" — before the sprint starts rather than after it slips.

On RedminePRO Cloud

Availability

Business and above.

Turn it on

Per project: Project → Settings → Modules → tick Resources. A Resources entry then appears in the project menu, and there is a cross-project view for planning across teams.

Permissions

Administration → Roles and permissions, in the Resources section:

Permission What it grants
Manage resource planning Set capacities, record leave for other people, and see the planning views

It is a global capability, because planning is a cross-project question — a person's week does not divide itself by project.

Settings

Administration → Plugins → RedminePRO Resources:

Setting Default Effect
Default weekly capacity (hours) 40 What a full week means for someone with no capacity of their own
Hours assumed for an unestimated issue 4 Applied to assigned open issues with no estimate
Default window (weeks) 8 How far ahead the views look to begin with
Over-utilization above (%) 100 Above this a week is shown as over-committed
Under-utilization below (%) 50 Below this a week is shown as under-committed
Users may record their own leave Off On lets people enter their own leave instead of asking a planner

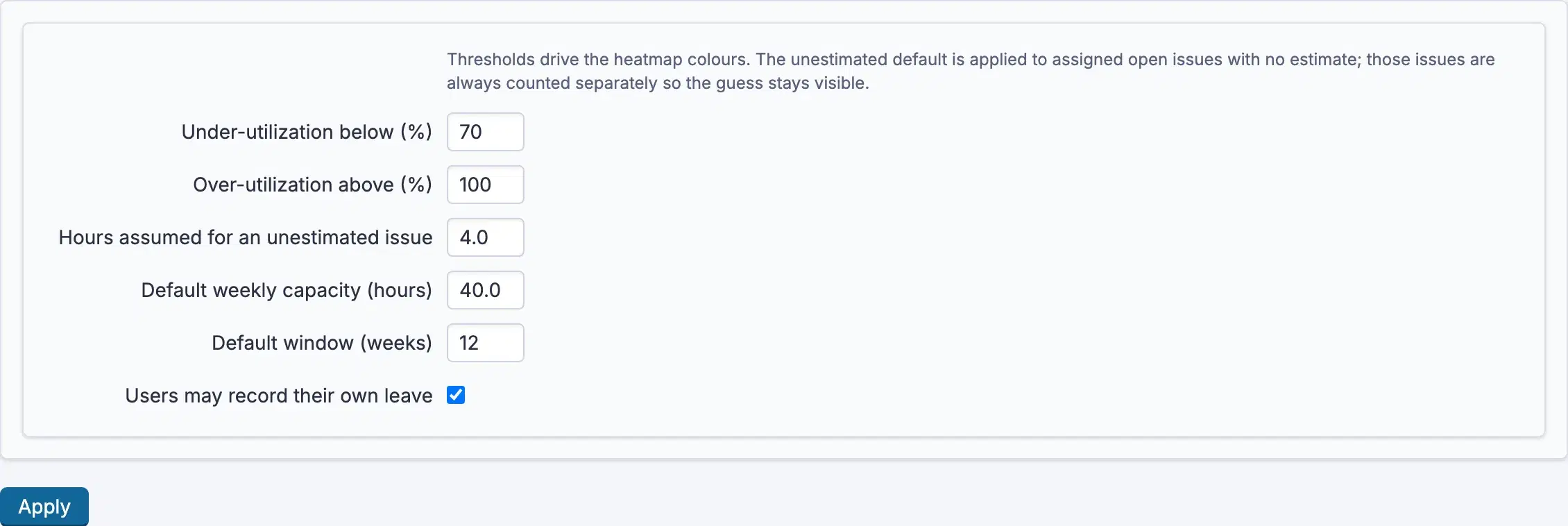

Capacity defaults and utilization thresholds
Capacity defaults and utilization thresholds

The two thresholds drive the heatmap's colours; set them to the numbers your organisation actually plans against.

The unestimated guess stays visible. Work with no estimate is counted using the assumed figure, but is always shown separately, so you can tell a plan built on estimates from one built on assumptions.

Using it

Who is committed to what, week by week
Who is committed to what, week by week
  1. Open Resources in a project, or the cross-project view for a whole team.
  2. Read the heatmap: each person by week, coloured by how committed they are against their capacity.
  3. Set capacities where somebody is part-time or splits their week.
  4. Record leave so a holiday reduces that week's capacity rather than quietly overloading it.
  5. Widen or narrow the window to plan further ahead.

Demand is an envelope, not a sum: a booking absorbs ticket work in the same project rather than adding to it, so a planned commitment and the tickets that deliver it are never counted twice.

Troubleshooting

Somebody's week looks far too full. Check for assigned open issues with no estimate — each is counted at Hours assumed for an unestimated issue, and a backlog of unestimated tickets inflates a week quickly. The unestimated portion is shown separately so you can see how much of the total is a guess.

Somebody's week looks empty and should not. Work counts when it is assigned to them and open. Unassigned work belongs to nobody and cannot appear.

A holiday is not reducing capacity. The leave is not recorded, or was recorded against a different period. Turn on Users may record their own leave if asking a planner every time is the bottleneck.

Everyone shows as over-committed. Over-utilization above (%) is a percentage of capacity, and the default assumes a full week means Default weekly capacity (hours). If your working week is shorter, set the capacity before adjusting the threshold.

The numbers differ from a time report. They are different questions. This shows committed work ahead; a time report shows hours recorded behind.
